Veterans Field

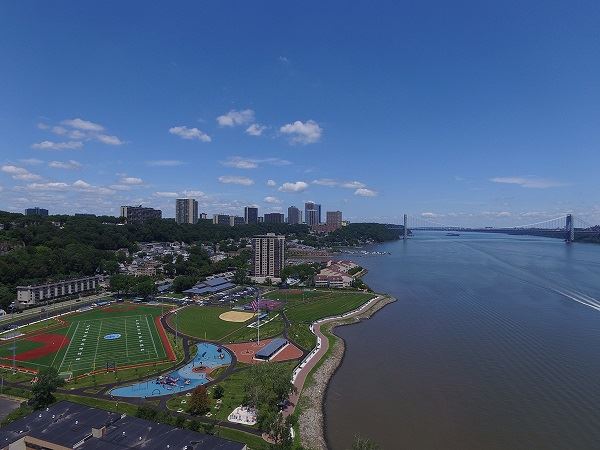

Project Completed June 30, 2017
The completion of Veterans Field is dedicated to our children and residents of Edgewater who endured too long without a place to laugh, play, splash, walk, run, and relax. As of June 30, 2017, this all changed with the spectacular grand re-opening of one of the best recreational facilities in Bergen County. The Borough of Edgewater thanks our children and residents for your patience during this process and welcome you to enjoy this facility for many years to come.
Work completed week of June 19

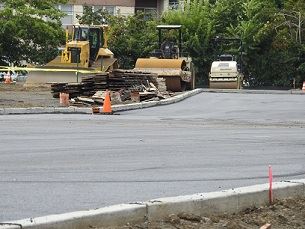

- Prepare for asphalt paving
- Spray park equipment installed
- Sod completed
- Site cleaned
- Comfort station interior
- System checks
Work to be completed week of June 26
- All asphalt paving
- Comfort Station
- Spray Park
- All punch list items
Work to be completed by Grand Opening
- Complete electrical work by June 14th
- Complete playground by June 24th
- Complete splashpark by June 24th
- Complete all sod by June 23rd – majority to be completed next week
- Final paving and striping week of park opening
Work completed week of June 5
- Fine graded for pavers around building
- Backfilled splashpark
- Continued irrigation heads
- Began playground equipment installation
- Topsoiling/sod preparation
- Concrete pad poured for splashpark
- Installed large scoreboard
- Set 911 monument

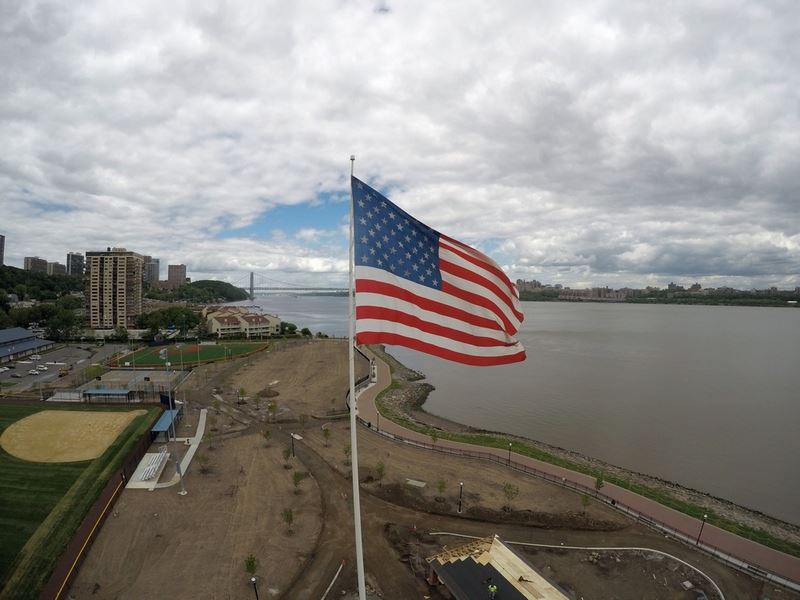

- Installed conduits for flagpole uplighting
- Poured curbs in building area
- Poured building patios
- LED sign to be installed on Friday
Work to be completed week of June 12
- Pulling wire and electrical work in building
- Continued topsoiling and sod preparation
- Sod installation
- Playground installation
- Seatwall cap installation
- Paver installation
- Community Center parking lot base repairs
- Set small scoreboard
Work completed week of May 30
- Splash park ground components completed and inspected by manufacturer. Approved to commence concrete installation.
- Base paving of walking paths.
- Adjusted inlet castings in splash park.
- Anchored Bleachers to pads.
- Performed concrete corrective work.
- ·Pillar masonry for LED Sign.
- Plumbing and electrical work of comfort station.
Work to be completed week of June 5
- Pulling wire
- Fine grading for pavers around building
- Back-filling splashpark
- Continue irrigation heads
- Playground equipment installation
- Topsoiling/sod preparation
- Continue sod installation
- Concrete for splashpark
- Miscellaneous concrete corrective work
- Continue plumbing and electrical work of comfort station.
- Splash park plumbing and ground component installation
- Splash park piping testing completed
- Electrician continued site wiring, meters, and disconnects
- 4 face clock was installed
- Topsoil preparation for un-sodded areas continued
- Dugouts were completed
- Bleacher assembly completed
- Player benches were installed
- All picnic tables but one were completed
Work to be Completed Week of May 30
- Splash park ground components to be completed and inspection by manufacturer to be performed
- Base paving of walking paths
- Electrician to continue pulling wire
- LED sign to be installed
- Playground equipment installation to begin
- Irrigation work to continue
- Topsoiling and sod preparation to continue
- Splashpark slab to be poured
- Building sidewalk and miscellaneous concrete corrective work to be constructed
- Sod installation
Work completed week of May 15
- Sod was installed on west side of site and in area of Community Center. Sodding of softball field and other areas to the east to be performed also.
- Bleacher installation continued and is expected to be completed by end of week
- Dugouts installation continued and is expected to be completed by end of week
- Dugout fence installation continued and is expected to be completed by end of week
- Grading and subbase installation for sitewide pathways continued
- Underground piping for splash park continued
- Masonry work for LED sign continued
- Remainder of clay pavers were delivered to site. Installation pending building construction
- Scoreboard footings and piers were backfilled
- Electrician scheduled to be onsite Friday to pull wire
- Comfort Station brick work and roof truss completed.
Work to be completed week of May 22
- Splash park plumbing to be completed and splash park ground components to be installed
- Electrician to continue site wiring, meters, and disconnects
- 4 face clock to be installed
- Base paving of walking paths to be installed
- Miscellaneous concrete work throughout site
- Topsoil preparation for unsodded areas to continue
- Comfort Station roof and indoor utility connections.
Work completed the week of May 8
- LED sign foundations were poured
- Scoreboard foundations were poured, pier sonotubes set, steel columns being erected
- Dugout Roofing installation continued
- Irrigation work continued
- Splash Park Plumbing was installed
- Topsoil installation continued
- Fence work continued
- Bleacher construction continued
- Curbing around building is being constructed
- Miscellaneous sidewalks were constructed
- Comfort Station block completed.
Work to be completed week of May 15
- Sod preparation and beginning of sod installation towards end of week
- Dugout roofing will continue and is expected to be completed
- Electrician pulling wire
- Fine grading of stone base for walking paths
- Base paving of paths towards end of week
- Playground equipment to be delivered and installation to begin
- Scoreboards to be delivered to site and installed once foundation is ready and cured
- Comfort Station truss roof installation.
Work completed week ending May 5
- Dugout Roofing- ongoing (Little League field complete, working on Baseball Field)
- Bleachers- ongoing ( Little League field erected, Baseball and Softball partial)
- Dugout 8’ Fencing ongoing
- Scoreboard foundations poured
- Curbing ongoing around building
- Soccer/football goals assembled placed on field
- Lacrosse Goals assembled placed on field
- Benches mounted at Hudson River Walkway
- Refuse enclosures placed around turf fields
- Inverts poured for storm sewer structures
(Building)
- Plumbing installed
- Backfilling performed
- Rebar tied for slab floor
- Floor poured
Work to be completed week of May 8
- LED sign foundation
- Backfill scoreboard foundation
- Pour Scoreboard beam piers
- Electrician to pull wires
- Dugout Roofing to continue
- Irrigation work to continue
- Fine grade for paths, begin base paving
- Splash Park Plumbing
- Clock next week or following week
- Seatwall cap installation
Work Completed week of April 24
- Installed water pipes from splash park toward building
- Irrigation main looped behind building, ran irrigation control wire.
- Dugout roofing ongoing
- Assembled picnic tables
- Installed pull strings for Musco conduit
- aluminum bleachers are ongoing
- Installed irrigation sleeves under walkways
- Installed fence posts for 8’ dugout fence
- Excavated for scoreboard footings
- Building contractor poured grade beams and pile caps
Work to be completed week of May 1
- Construct scoreboard footings
- Pour building perimeter curb for pavers
- Continue dugout roofs
- Continue bleacher Installation
- Continue irrigation work
- Continue base preparation for paths
- Install splash Park Plumbing
Work completed week of April 17
- Began dugout roofs
- Began bleacher installation
- Dugout fencing installation
- Continued topsoil installation
- Continued asphalt path preparation
- Continued tree installation
- Continued irrigation work
Work to be completed week of April 24
- Continue topsoil installation
- Continue asphalt path preparation
- Began base paving of paths
- Pulling electrical wiring
- Continue dugout roof installation
- Complete dugout fencing
- Scoreboard footings
- Sod preparation
- Miscellaneous concrete work
- Electric service and water hot box
Anticipated Scheduling
- Sod scheduled for first week of May
- Playground equipment installation scheduled for week of May 15
- Splashpark underground equipment to be delivered by end of next week and installation will begin. Schedule of delivery of bollards and stacks expected mid-June
- Clock is on site, installation to be scheduled
- Rubber surfaces scheduled for early June
- Community Center playground preparation for surfacing to be performed in early May. Playground will be inaccessible until surface is installed
- Dugouts anticipated to be completed by May 5th
- Miscellaneous site furnishings are all on site and will be installed as other work progresses
- Scoreboards are shipping May 3rd
- LED sign is shipping to sign installer on May 3rd for assembly and testing
- We met with a net manufacturer/installer yesterday to review options for foul ball netting.
Work Completed week of April 10
- Bldg. contractor connected plumbing to 4” sewer lateral, (interior plumbing installed)
- Began tree installation
- Installed water meter , pressure tested all lines, disinfected, and flushed. Test samples to be taken by end of week
- Topsoil work ongoing
- Asphalt path preparation
- On site template for seat wall bluestone cap being prepared
- Poured outer circle and inner circle of splash park flush curbing
- Poured concrete path to end of retaining walls between fields
- Poured remaining picnic table pads
- Complete conduits to disconnect switch meter pad
Work to be completed week of April 17
- Begin dugout roofs
- Begin bleacher installation
- Player bench installation
- Dugout fencing installation
- Continue topsoil installation
- Continue Asphalt path preparation
- Continue tree installation
- Irrigation work
- Grading for pathways
- Continued topsoil placement
- Completed dugout pads and installed some picnic table pads
- Constructed utilities in building area
- Water meter installed by Suez
Work to be completed week of April 17
- Continue utilities in building area
- Construct park bench and refuse receptacle pads
- Tree planting
- Topsoil placement
- Stone base for pathways
- Splashpark curbing
- Dugout roof installation
- Dugout fence post installation
- Irrigation work
Work completed week of March 13
- Hooked up supply lines and set (3) drinking water fountains on concrete footings
- Placed non shrink grout around and trimmed anchor bolts, in preparation for dugout pads.
- Spread Topsoil at west parking lot near turf baseball field, transformer area , and toward the north direction.
Work completed week of March 27
- Prepared site for Opening Day on April 1
- Concrete flatwork including dugout pads and sidewalks
- Topsoil placement west side of site
- Electric conduit backfilling
- Began picnic table installation
- Flush box hydrant installed
- Backflow preventer installed
- Comfort Station Pilings completed
Work to be completed week of April 3
- Grading pathways
- Topsoil placement
- Begin tree planting
- Continue concrete flatwork including walks, dugout pads and bench pads
- Utility excavation and installations in building area
- Requesting meter install from Suez
- Comfort Station Foundation
- Scour hole at outfall structure
- Sanitary sewer lateral installation
- Sanitary sewer lateral testing
- Electrical box and conduit installation on secondary side
- Fence gate posts
- Concrete dugout pads, sidewalks and bench pads on Friday (weather permitting)
Work to be completed week of March 27
- Prepare site for Opening Day on April 1
- Concrete dugout pads, sidewalks and bench pads on Friday (weather permitting)
- Topsoil placement west side of site
- Electric conduit backfilling
- Picnic table installation
- Cleanup of front parking area
- Comfort Station Pilings
- Preparing subgrade in playground area
- Water system testing
- Installed grills in picnic area
- Installed stone along fences
- Earthwork and grading on north side of turf fields
- Masonry work in drainage structures
- Staked out some of the tree locations
- Team enclosure frame delivery and installations
- PSEG completed lighting installation

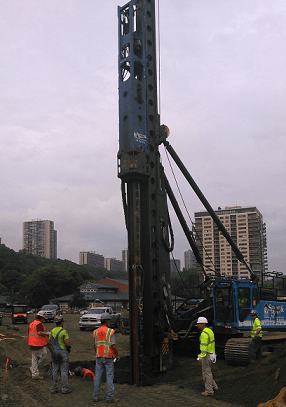

- Pile driving commenced for building
Work to be completed week of March 6
- Complete installation of dugout framing
- Subgrade preparation on westerly portion of property
- Flared end section and scour hole installation for the stormwater outfall
- Possible sidewalk construction subject to availability of subcontractor
- Seatwall construction continued including center circle
- Installing Delaware River gravel along walls
- Installed picnic table foundations
- Poured sidewalks near cart corral and along River Road
- Continued chain link fence installations
- Installed fence guard on softball field fence
- Poured cart corral slab
- PSEG continued lighting in park and along river
- Building contractor excavated for footings and grade beams
Work to be completed week of February 27
- Installation of water fountains
- Installation of grinder pump pipe stub for building connection
- Installation of grill foundations in picnic area
- Electrical conduit work
- Subgrading of splashpark and playground area and installation of flush curbs
- Pile installations for building
Work completed the week of February 13
- Set castings and grates for yard drains splash park.
- Poured concrete exercise pad.
- Poured Hot Box concrete pad.
- Installing cart corral fence posts.
- Installing yellow fence guard.
- Installing flush box hydrants
- Continuing split face block at seatwall on Saturday, and Sunday if necessary.
- Removed staged materials at building area.
- Poured some remaining sections of sidewalk.
- PSEG continued lighting installations.
Work to be completed week of February 20
- Installation of drinking fountains with footings.
- Earthwork on north side of turf fields.
- Delaware river gravel installation.
- Flared end section and scour hole at storm outfall.
- Building excavation to commence Monday and possibly pile installation towards end of week
Work completed the week of February 6
- Installed 6” pvc drain pipe and yard inlets for splash park
- Set decorative clock precast foundation in place and connected electrical conduit.
- Set picnic table and grill precast foundations for picnic grove
- Began installation for split face block/seatwall construction.
- Graded and installed stone subbase for exercise equipment pad near Hudson River.
- Formed hot box concrete pad
- PSEG continued pulling wire for site lighting east of the ball fields and at great lawn area.
- PSEG continued installing decorative light poles and fixtures at community center and west parking lot.
Work to be completed week of February 13
- Set castings and grates for yard drains splash park
- Pour concrete exercise pad
- Pour available sidewalk
- Pour Hot Box concrete pad
- Install cart corral fence posts
- Install yellow fence guard
- Install softball field bases with ground posts.
- Install flush box hydrants and drinking fountains with footings
- Continue split face block at seatwall
- Remove staged materials at building area
- Start construction of comfort station (weather permitting)
Work completed week of January 30
- Infield Mix at Softball Field
- Warning Track Mix at Softball Field
- !2” storm pipe at playgrounds
- PSEG- set transformers, utility poles, wiring, begin site lights for site, started at Community Center
- Suez Water- Installed Fire Hydrant
- Yard drains and pipe for splash park
Work to be completed week of February 6
- Decorative seat wall block –weather permitting
- Construction of storm sewer outfall including rip rap scour hole and flared end section
- Concrete pads for exercise equipment and dugouts.
- Fence for cart corral.
- Yellow fence guard installation
- Water extension into splash-park
- Completed dugout footings
- Installed sanitary sewer pump station unit for building
- Backfilled seatwall
- Starting spraypark drainage system
Work to be completed week of January 30
- Installation of finish block for seatwall
- Installation of ballast for pump station unit
- Trench drain concrete pour
- Clay mix, warning track mix and base installation, weather permitting
- PSEG scheduled to begin electric service and transformers. They have also issued a workorder for the site lighting to commence.
- Excavating for, forming and pouring of trench drain
- Softball field fencing
- Softball field backstop
- Lower courses of seatwall block
- Bleacher pad construction
- Drilling for dugout footings
- Sidewalk and handicapped ramp at westerly parking lot and sidewalks near bleacher pads
- Foul pole assembly and installation
Work to be completed week of January 16
- Set dugout footings
- Complete lower block on seatwall
- Complete bleacher pads
- Install infield clay mix and warning track mix
- Pour dugout pads
- Install water service for splashpark
- Set softball field bases
- Electric conduit extensions where necessary
Week of 01/2 to 01/6
- Began installation of fence fabric on softball field backstop.
- Installation of 12’ gates at turf fields.
- Continued pathway lighting ground rods and pull strings & site conduits pull strings.
- Obtained PSEG approval for all site transformer pad bases.
- Concrete sidewalks formed (pour to be scheduled based on weather).
- Continuation of irrigation system installation.
- CMU block delivered to site for lower courses of seat wall (installation to commence Monday, weather permitting).
Week of 12/26 to 12/30
- Installed fence gates.
Week of 12/19 to 12/23
- Installation of irrigation main, valves, laterals and risers continued.
- Backstops for turf Baseball and Little League Field were completed.
- The seat wall footing was poured at the playground area.
- Commenced backstop framing for softball field.
- Poured bleacher pads at turf baseball field on 1st and 3rd base sides.
Work completed week of December 19
- Continued fence installation. Ornamental fence is complete and chain link fence and backstop work continues.
- Seatwall reinforcement is complete. The footing will be poured as soon as weather permits.
- The irrigation lines are installed with exception to the building area and other small areas where Tomco is working.
Work to be completed week of December 26
- Fence installation will continue.
- Bleacher pads and walkways will continue as weather permits.
Work completed week of December 12
- Continued decorative fence installation
- Base paving installed at southerly entrance
- Suez completed water tap
- Continued seatwall reinforcement installation
- Continued irrigation installation
- Poring bleacher pads and walkways
- Continued topsoil installation
- Conduit installation for LED sign
Work to be completed week of December 19
- Continuing fence installation
- Continue seatwall reinforcement. Footing to be poured subject to weather conditions
- Irrigation work will continue
- Bleacher pads and walkways will continue
- Sodding tentatively scheduled subject to weather conditions and availability
- Topsoil installation and grading will continue
- Fence work continued
- Curb and sidewalk work continued
- Conduits, pull strings and junction boxes
- Seatwall foundation formwork
- Irrigation work continued
-
Work to be performed Week of December 19:
- Basketball court trench drain
- Subgrade preparation
- Seatwall foundation pour
- Asphalt repairs in Community Center lot
- Removal of excavated materials
- Topsoiling Community Center area
- Irrigation work will continue
- Work performed week of November 28:
- Fence work continued
- Curb and sidewalk work continued
- Conduits, pull strings and junction boxes
- Seatwall foundation formwork
- Irrigation work continued
- Work to be performed week of December 5:
- Basketball court trench drain
- Subgrade preparation
- Seatwall foundation pour
- Asphalt repairs in Community Center lot
- Removal of excavated materials
- Topsoiling Community Center area
- Irrigation work will continue
Work Completed Week of November 21
- Completed all underground conduits to terminus JB locations to North & South of future Bldg. and backfilled.
- 4x4, 6x6, 14” x 24”, 12” x 12” JB boxes delivered to site. Installation being scheduled.
- Poured sidewalk and handicap ramps around Community Center.
- Curbs poured this week for new west parking lot. Complete to River Rd, and North entrance.
- Decorative fence installation continued along wall.
- All 2” hdpe water line complete up to flush hydrants and water fountains.
Work to be completed Week of November 28
- Seatwall reinforcement and foundation.
- Pour and install trench drain behind basketball court
- Continue sidewalk installation.
- Complete curb in Community Center area.
· Conduit runs on south side of site
· Curb at Community Center
· Preparation work for sidewalk pours
· Concrete infill along river walk
· 2” water line on west side turf fields and main water service for site
· Softball field fence posts behind retaining wall
· Began decorative aluminum fence behind retaining wall
Work to be completed week of November 21.
· Irrigation pending approvals
· Curb and sidewalks including sidewalk at Community Center.
· Continuation of 2” water lines
· Terminate conduits in junction boxes.
· Pour seat wall footing
· Continue fencing
· Modular block walls completed
· 6” water main completed up to Backflow Preventer
· Sanitary force main installed
· Storm pipe and manhole installed near River Road
· Transformer pads prepped
· Tide Gate work done reset top slab and backfilled structure
Work to be completed week of November 14;
· Finalize conduit termination points near building
· Install 6” water main near river road
· Install 2” HDPE pipe for flush hydrants and Water fountains
· Complete Backstops and Fence for turf fields
· Install fence posts for softball field behind retaining wall
· Final inspection by PSEG for underground work associated with site lighting
Work performed week of October 31:

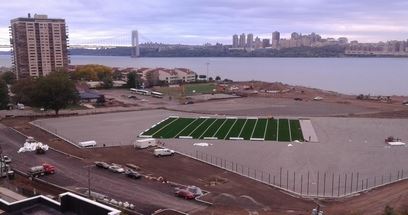

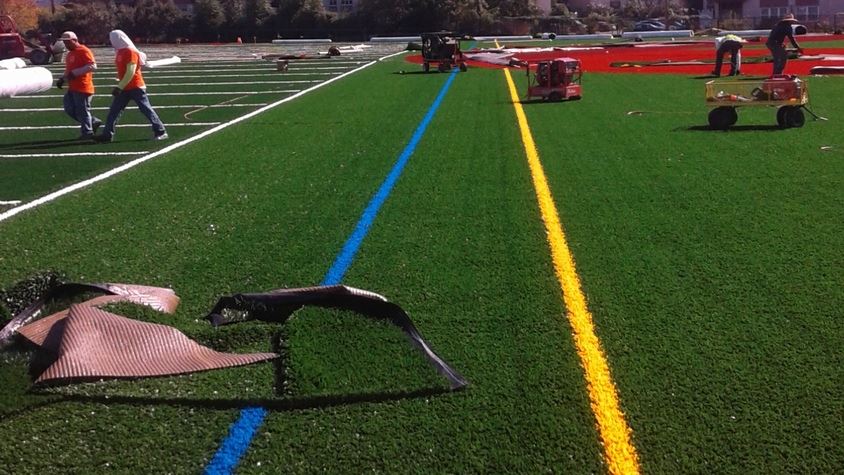

- Turf infill has been completed.
- PSEG conduit and transformer pads.
- Exported excavated materials (still small amount to export). First Environment is being kept apprised of the status.
- Topsoil installation for softball field.
- Fence installation around turf field.
- Modular block retaining wall.
- Water service to meter pit location.
- Sanitary manhole adjacent to proposed building.
- Excavated for sanitary sewer service line.
- Storm drainage near Community Center.
- Preparation work for sidewalk near Community Center and concrete along river walk.
- Completed site lighting bases, conduit and handholes.
Work to be performed week of November 7th:
- Concrete sidewalk and curbing.
- Sanitary sewer service line.
- Miscellaneous conduit.
- Water service.
- Fence for turf fields.
- Completion of retaining wall.
- Continue topsoil installation

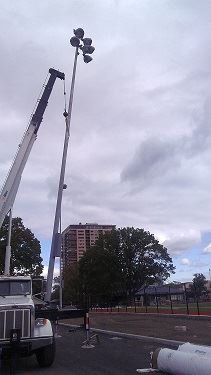

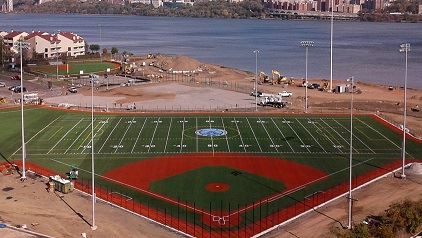

- All field lighting poles and light masts installed.
- Nearly all PSEG site lighting foundations and conduit installed.
- About 40% of the stockpiled historic fill has been trucked off site.
- Area along the existing paver river walkway has been graded to receive concrete surface with box outs for tree installations.
- Sleeving for irrigation piping under proposed pathways was installed.
- Retaining wall installation commenced.
- Turf cool play infill installed.
- Foul Pole foundations installed.
- Removed fence and vegetation along south side of site.
Work scheduled for week of October 31:
- Continue conduit installation.
- Continue retaining wall installation.
- Fabric to be installed on backstops and fence posts surrounding turf fields once FieldTurf installation is complete.
- Meet with PSEG to review primary electric requirements and transformer locations.
- Spread topsoil.
- Continue export of historic fill.
- Connect existing inlet at River Road to site drainage.
- Borough’s contractor to install new fence along south side of site.
- Install water main.
- Rough grading of site frontage along River Road
- Segregation of rocks and boulders from historic fill in preparation for removal
- Piers for sports lighting were completed
- Continuation of site lighting bases, underground electrical work and irrigation sleeves
- The tide valve has been installed
- Completion of synthetic turf carpet installation
- Softball field fence posts
- Foul poles scheduled for tomorrow
Work to be performed week of October 17:
- Turf infill subject to approvals from the LSRP
- Continuation of topsoil installation subject to approvals from the LSRP
- Continuation of site lighting bases, underground electrical work, field lighting conduits and supplemental conduits requested by Borough
- Installation of infield clay mix and warning track mix on softball field subject to LSRP approvals
- Sanitary sewer upon delivery of pipe
- Begin removal of stockpiled soils (approximately 50 loads per day, 4 day duration)
- Retaining wall installation upon delivery of block
- Backfilling of field lighting bases and utility trenches
Work Completed Week of October 3:
- Field turf installing synthetic turf for ballfields
- Installing light foundations and conduit for site lighting – 25%+/- complete
- Fence installation around softball field
- Pile caps for sports lighting completed
- Installing subbase for sitewide pathways
- Grading of softball field completed
- Began importing and spreading topsoil
- Continued earthwork – 95%+/- complete
Work to be Completed Week of October 10:
- Grading site frontage along River Road once conduit runs are completed
- Pouring piers for sports lighting
- Continuation of site lighting, electrical work and irrigation sleeves
- Pouring of seatwall footing
- Continuing importing and spreading of topsoil
- Pouring sidewalks and curbs
- Installation of tide valve
- Continuing synthetic turf installation
- Sanitary sewer force main installation
Work completed week of September 30:
- Backstop posts installed
- Curbs around field completed
- Completed fine grading of field stone
- Installing timber nailer on curb for turf installation
- Graded to subgrade elevations around turf field
- Imported and placed dense graded aggregate for sitework
- Installed drains and placed stone in natural turf softball field
- Constructed sanitary sewer tie in into River Road
- Tide valve delivered and attempting to install subject to river tides
- Sampled excavation stockpile for classification and disposal
- Field turf has begun mobilizing and deliveries to the site
Work to be completed week of October 3:
- Field turf installing synthetic turf for ballfields
- Installing light foundations and conduit for site lighting
- Fence installation around softball field
- Grading site frontage along River Road
- Continuation of piers and sports lighting precast bases
- Installing subbase for sitewide pathways
- Grading of softball field

Work performed week of September 19
- Installation of reinforcement steel for field lighting foundations
- Begin pouring foundation slabs for field lighting.
- Installation of backstop footings and poles.

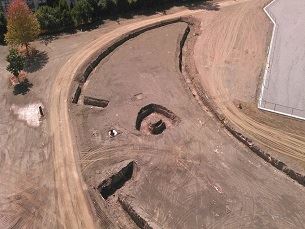

- Completed excavation in vicinity of playground and softball field.

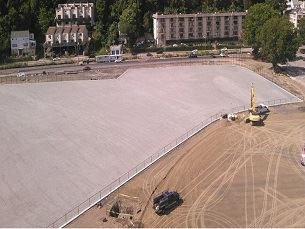

- Sub grading completed for Softball Field, Playgrounds, Open Lawn areas to south and East, and HMA paths.
- Completed excavation for Decorative Seat Wall around perimeter of playgrounds.
- Completed percolation testing of turf field subbase.
- Installed dog house manhole no. 2
Work scheduled for week of September 26
- Continue pouring lighting foundations.
- Continue earthwork in easterly portion of project.
- Install connection to existing sanitary sewer manhole in River Road.
- Construct 15” collector pipes for natural turf softball field.
- Complete curbing around fields and nailer board for turf.
- Perform final inspection of field subbase with Field Turf and schedule turf installation.
- Begin Precast PSEG site lite bases, conduit, and irrigation sleeving at community center parking lot area.

Work Completed Week of September 12
- Excavation of subsoils on the easterly side of the site.
- Site grading.
- Excavation for proposed retaining walls and seating wall surrounding playground
- Tying rebar and welding L-hooks on driven piles in preparation for pouring light foundations
- Drainage testing of field subbase.
Work to be Completed Week of September 19
- Continue with rebar work for field lighting.
- Begin pouring foundations for field lighting.
- Excavate and pour backstop footings.
- Forming seating wall foundations pending submission/approval of footing design.
- Storm sewer work continued; 95% +/- complete
- Top rail of field fencing is being installed
- Completed grading of field stone and obtained as built of grades. Grades being sent to Field Turf for review
- Excavation for modular block walls
- Earthwork in westerly portion of site
Work to be completed week of September 12
- Installation of reinforcement steel and pouring of pile caps for field lighting
- Backstop footings
- Complete curb around field
- Continuation of earthwork
- Testing of field drainage
Work to be completed week of September 6
- Begin installation of rebar for Musco lighting pier caps.
- Install top rail on fencing surrounding turf fields.
- Continue installation of remaining site storm sewer.
- Preparatory work for retaining walls.
Work completed week of August 29
- West parking lot HMA base course installed to allow staging area for Field Turf. Portions omitted where future trenching anticipated.
- Finish stone on turf field areas completed and survey performed. CME to review.
- PSEG removed wires from utility poles to be removed.
- Bulk of storm drainage work completed. Softball field drainage not yet completed.
Week of August 29
- Begin base paving of parking area
- Complete finishing stone and survey field grades
- Complete drainage work
- Continue earthwork on easterly side of site
Week ending August 19
- The contractor worked predominantly on the installation of the lighting piles throughout the week including the splicing and driving of piles that went deeper than anticipated by the lighting manufacturer’s design.
- The contractor continued with the installation of storm drainage improvements.
- The turf supplier has been authorized to manufacture the turf and field graphics.
- The amended construction plans have been submitted to the Borough for review and we have received comments that are being addressed.
- The retaining wall style has been determined in consultation with the Borough.
Work scheduled for week of August 22
- Paving of westerly parking area where necessary for Field Turf staging of materials.
- Continuation of pile splicing and driving.
- Continuation of field grading and placement of finishing stone.
- Installation of field fencing where possible prior to turf installation.
- Forming and installation of reinforcement steel for pile caps.
Week of August 15
- Piles were completed
- Placing finishing stone on turf fields
- Storm sewer installation
Week Ending August 12, 2016:
- Installed remainder of field drains and base stone for synthetic turf fields
- Driving piles for field lighting and basketball courts.
- Construction of parking area curbing
- PSEG relocated gas main to allow for storm sewer installation
Work scheduled for the week of August 15th:
- Grading base stone and installing finishing stone for synthetic turf fields
- Complete pile driving for field lighting
- Sidewalk construction
- Begin base pavement installation for parking area between fields and River Road
- Storm drainage construction
- Complete fabric and flat drain installation.
- Begin importing stone for field base course and grading.
- Begin pile installation for Musco light foundations.
- Continue site curbing and begin sidewalk installation.
Progress Week Ending August 5
- Installed concrete curbs in western parking lot and around community center. The western parking lot curb is 50% +/- complete.
- Installed site drainage in western parking lot.

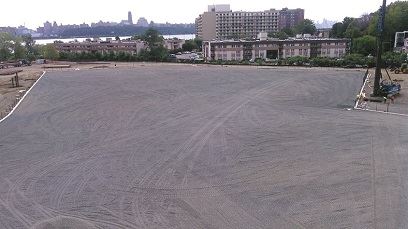

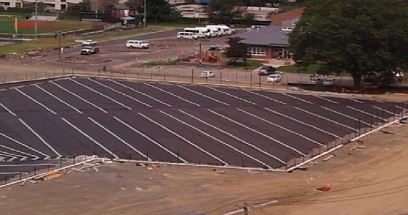

- Installed filter fabric and flat drains over synthetic field areas. This work is anticipated to be completed today or Monday.
Week thru July 22
- Site sub-grading completed with exception of areas in southeasterly portion of site.
- All line, end, and corner fence posts for synthetic turf installed (not backstops).
- Perimeter curbing forming and pouring began this week, ongoing today.
- Drainage trunk lines, structures, stone backfill installed for perimeter limits of multi sports field.
- Continuing trunk line installation.
- Survey layout for site ongoing.
- Precast deliveries for site drainage structures received this week.
- Stockpiling of historic fill and clean DGA is ongoing
- Pole removals for site are being coordinated with PSEG.
- Water service application is being prepared.
- Shop drawing submittals ongoing.
- Field turf rep. on site 7/21 and confirmed turf will be ready for installation per schedule.
Week Ending July 29
- Continue trunk line drain pipes and structures for turf fields.
- Continue perimeter curb for turf fields.
- Contractor to do subgrade touch ups and survey for turf fields.
- Begin subgrade fabric and drains for turf fields.
- Begin installation of stone base for turf fields.
- Site curb and sidewalk pours.
Week of July 18, 2016 - Tomco has completed the following this week:
· Site subgrading completed with exception of areas in southeasterly portion of site.
· All line, end, and corner fence posts for synthetic turf installed (not backstops).
· Perimeter curbing forming and pouring began this week, ongoing today.
· Drainage trunk lines, structures, stone backfill installed for perimeter limits of multi sports field.
· Continuing trunk line installation today.
· Survey layout for site ongoing.
· Precast deliveries for site drainage structures received this week.
· Stockpiling of historic fill and clean DGA is ongoing
· Pole removals for site are being coordinated with PSEG.
· Water service application is being prepared.
· Shop drawing submittals ongoing.
· Field turf rep. on site 7/21 and confirmed turf will be ready for installation per schedule.
Next week:
· Continue trunk line drain pipes and structures for turf fields.
· Continue perimeter curb for turf fields.
· Tomco to do subgrade touch ups and survey for turf fields.
· Begin subgrade fabric and drains for turf fields.
· Begin installation of stone base for turf fields.
· Site curb and sidewalk pours.
July 7, 2016: Veteran’s Field Update through July 11, 2016
Week of July 5
The contractor has mobilized additional operators , drivers , and laborers to expedite the work, they have performed the necessary excavation of grade, loaded and hauled the dense graded aggregate material to areas of the site in need of fill. The contractor has also began spreading and compacting the fills to achieve the required subgrades for the improvements such as the athletic fields and walkways. Areas of pavement in the parking lot were saw cut to prepare for curb and sidewalk installation. All of this work will continue for the remainder of the week.
Next week’s schedule calls for the earthwork operations to continue , curb layout for fields and parking lot will be performed, and they anticipate commencing the curb construction by the end of the week.
June 24, 2016: Veteran’s Field Update as of June 24, 2016
- The following work was completed for the week ending June 24, 2016;
- The entire existing storm sewer system was abandoned in place;
- The walls on the north side of the site were removed;
- The wall improvements along the river were completed;
- The survey layout was performed;
- The stockpiled materials from the previous project were staged outside of the work zone.
- The following work is scheduled for the week of June 27, 2016;
- Earthwork operations to cut and fill the site to rough grade;
- Excavation for the proposed retaining walls;
- Demolition of curbs and walkways as necessary;
- Storm drainage improvements will commence on or about next Friday.
June 9, 2016: Veteran’s Field Project Update
The Borough of Edgewater held what is called a “pre-construction meeting” yesterday, Wednesday June 8, 2016 at the Edgewater Community Center. This meeting was attended by representatives of Tomco Construction, the contractor hired by the Borough to begin work on the final phase of Veteran’s Field, CME Engineering, the Borough’s Municipal Engineer, who designed the project, and representatives of the Borough, which included the Borough Administrator, Public Works Superintendent, and Mayor McPartland. A pre-construction meeting is considered the “kick-off” to the project whereby a discussion is held in regard to the methods and procedures for the start of the work, permits and licensing, payment certifications, work hours, and any other matter that needs to be discussed prior to the start of work. The Borough is happy to report that Tomco Construction said they can be on site mobilizing, or preparing the site such as the placement of silt fencing, and bringing in the necessary equipment and supplies, as early as Monday June 13.
May 21, 2016: Parts of Veterans Field may open by fall NorthJersey.com
May 20, 2016: VETERAN’S FIELD TO BE COMPLETED
The Mayor and Council unanimously awarded a $7,471,110.89 contract to Tomco Construction of Mount Arlington New Jersey at the Mayor and Council meeting of Monday May 16 for the final completion of Veteran’s Field. Tomco Construction was the successful bidder who completed the little league field and Community Center parking lot last year, on time and on budget. Mayor McPartland was pleased with this award “this has been a difficult, tedious, and arduous road to get to this point, but we are at a good place”, saying after the meeting. The Mayor and Council had to advertise for two separate bids since January due to only one bidder submitting a bid the first time, that bid in excess of $12million, was deemed over budget by about $4.5million. The borough’s engineer, CME Associates, had estimated the final phase of the project to be about $8.5million. The bid was structured so that if the Mayor and Council felt the bids were excessive for certain components, those components could be removed to pare down the project scope and cost. This was done for the Tomco award, removing items such as fencing and a comfort station. The contingency plan prepared before the bidding was that if components were removed due to cost, the borough would consider bidding out those removed items separately or perhaps have the Public Works Department install some features. The work should begin sometime in June and as components are completed, those components will be opened to the public.
May 20, 2016: Edgewater awards trimmed contract for field. NorthJersey.com
May 16, 2016: Resolution 2016-134 Veteran's Field Bid Award
May 6, 2016 : Costs for Veterans Field in Edgewater continue to rise. NorthJersey.com
Introduced Bond Ordinance 2016-1534
April 29, 2016 : Edgewater council to decide on field bids Monday May 16,2016. NorthJersey.com
NorthJersey.com
